Introduction

In the ever-evolving landscape of renewable energy, the Nordic countries stand as beacons of sustainable progress. Their commitment to renewable energy sources, including solar power, has ignited a green revolution. But beneath the surface of this promising frontier lies a complex web of grid systems—a pivotal aspect often overlooked in the quest for solar development.

As solar developers across the globe set their sights on the Nordics, they find themselves at the intersection of innovation and challenge. Each Nordic nation—Norway, Denmark, Sweden, and Finland—offers a unique tapestry of opportunities and obstacles, all intricately woven into their grid systems.

In this journey, we unveil the Nordic grid system's enigmatic layers—exploring recent developments, disruptive partnerships, and research-backed insights. From Norway's robust hydropower-fueled grid to Sweden's quest for transparency, and Denmark's interconnected energy ecosystem to Finland's blend of sustainability and efficiency—we delve into the essence of each grid.

The Nordic Power System: Challenges and Insights

The Nordic power system comprises Norway, encompassing Sweden, Denmark, and Finland, and is a complex and interconnected energy ecosystem.

One of the main challenges of the power system is the need to balance production and consumption continuously. This demand for constant equilibrium necessitates flexibility, the controllable aspect of production and consumption that can be adjusted to maintain balance. Flexibility is particularly important when more intermittent energy sources, such as solar energy, are installed into the grid. It is hence important that renewable energy developers take this into account, and we will therefore delve into the intricacies of grid flexibility.

Flexibility from producers

Today, flexibility is most relevant on the production side. In the Nordic region, this encompasses hydropower plants with reservoirs (especially hydropower plants with the ability to pump up water), thermal coal, and gas power plants. Historically, the Nordic region has benefited from abundant flexibility, particularly from hydropower plants with reservoirs. Hydropower accounted for 88.2% of the total electricity output in the Nordics in 2022. These reservoirs allow for the accumulation of water over extended periods, with minimal cost associated with adjusting power output. Flexible thermal coal and gas power plants have also contributed to meeting flexibility demands.

Flexibility from consumers

Consumer flexibility is less recognized but valuable. Residential and industrial users can adjust their consumption based on market signals. Currently, Nordic end-users are relatively inflexible, responding more to high energy prices. During energy shortages, high prices encourage producers to maximize output and consumers to reduce usage. Although consumer-level flexibility sources are limited now, the emergence of EV batteries and smart homes is introducing more flexibility to the demand side.

Time horizons and flexibility needs

Different time horizons require varying degrees of flexibility. These include long-term balancing to account for seasonal and yearly variations, medium-term adjustments between months, weeks, and days, and even finer adjustments on a day-ahead, intraday, and operational basis.

Impact on the market - Nord Pool:

The growing demand for flexibility, coupled with limitations in existing hydropower and thermal production, is expected to lead to increased price volatility in day-ahead markets and higher operational balancing costs. In addition, greater fluctuations in power flow and larger imbalances may necessitate additional reserves. Running the Nordic energy market, Nord Pool has a pivotal role in facilitating and incentivizing new mechanisms that will fit this new technical situation.

Ensuring adequate transmission capacity:

Grid flexibility relies on available transmission capacity. Managing grid congestion plays a central role in ensuring system stability and efficient resource utilization. Geographical imbalances in primary reserves and a lack of Regulation Power Market (RPM) bids during critical periods create congestion challenges in the southern part of the Nordic region (refers to SE3, SE4, Southern part of Finland and Denmark), affecting both reserves and system security.

Changing landscape and the way forward

The ongoing electrification of society implies a need for more energy, and the energy is required at different times than today. As an example, the electrification of the transport sector (both private and industrial) is highly challenging for the current grid.

This shifting pattern of energy consumption paints a formidable challenge for it as well. Furthermore, we are witnessing substantial changes on the production side. The dominant trend here revolves around the increasing integration of intermittent renewable energy sources and a more decentralized approach to energy production. This new production scheme sets new requirements for flexibility at other production units. The increased share of distributed production challenges the grid capacity. In many countries, the grid is historically not dimensioned for such distributed energy production. Additionally, the introduction of greater transmission capacity to neighboring systems further intensifies competition for the low-cost flexibility offered by hydropower.

Grid operators find themselves navigating through an era of profound change. They must adapt to evolving consumption patterns while simultaneously managing a radically different energy production landscape, and all of this must happen at an unprecedented pace. For most countries, this is a completely new situation, and the problem is so far largely theoretical. In order to provide a secure and stable energy situation, all parts of the energy system must work together:

  • The energy market, exemplified by Nord Pool in the Nordics, needs to undergo transformation to provide the right incentives for renewable energy adoption and reward flexibility.

  • Governments and policymakers must craft innovative policies and subsidies that promote decarbonized production and consumption, a fair market, and eliminate existing friction.

  • Energy producers must pivot away from fossil fuels toward renewable energy.

  • The energy consumers (both industrial and private) must also be greener, as well as smarter - ideally, they should respond quickly to market signals and deliver more flexibility

Each of these elements plays a critical role in the ongoing energy revolution we are witnessing. If any part lags behind or fails to align with the others, it could lead to bottlenecks, impeding the entire process of transformation.



Main Nordic power trends towards 2025

The Nordic power system is undergoing significant structural changes, and as a solar developer, below are the key trends you should be aware of:

  • Grid capacity: As in most grids in Europe, grid capacity is always a challenge. As competition for developing renewable energy is sharpening, securing capacity early is key. Grid upgrades take many years, and available capacity on suited solar sites will quickly be reserved. Solar developers therefore need to act quickly.

  • Closure of thermal power plants: Thermal power plants are gradually being phased out. This shift aligns with the broader European goal of reducing carbon emissions and transitioning to cleaner energy sources.

  • Rise of renewable energy: The share of renewable energy sources (RES) in the energy mix is growing, while coal and gas capacities are declining. This emphasizes the region's commitment to sustainability.

  • Nuclear power dynamics: Sweden is decommissioning nuclear power plants earlier than planned, whereas Finland is investing in new nuclear facilities. Understanding these dynamics can help you assess future energy supplies.

  • Enhanced connectivity: More interconnectors are linking the Nordic power system with Continental Europe, the UK, Russia, and the Baltic system. This increased connectivity offers opportunities for cross-border energy trading.

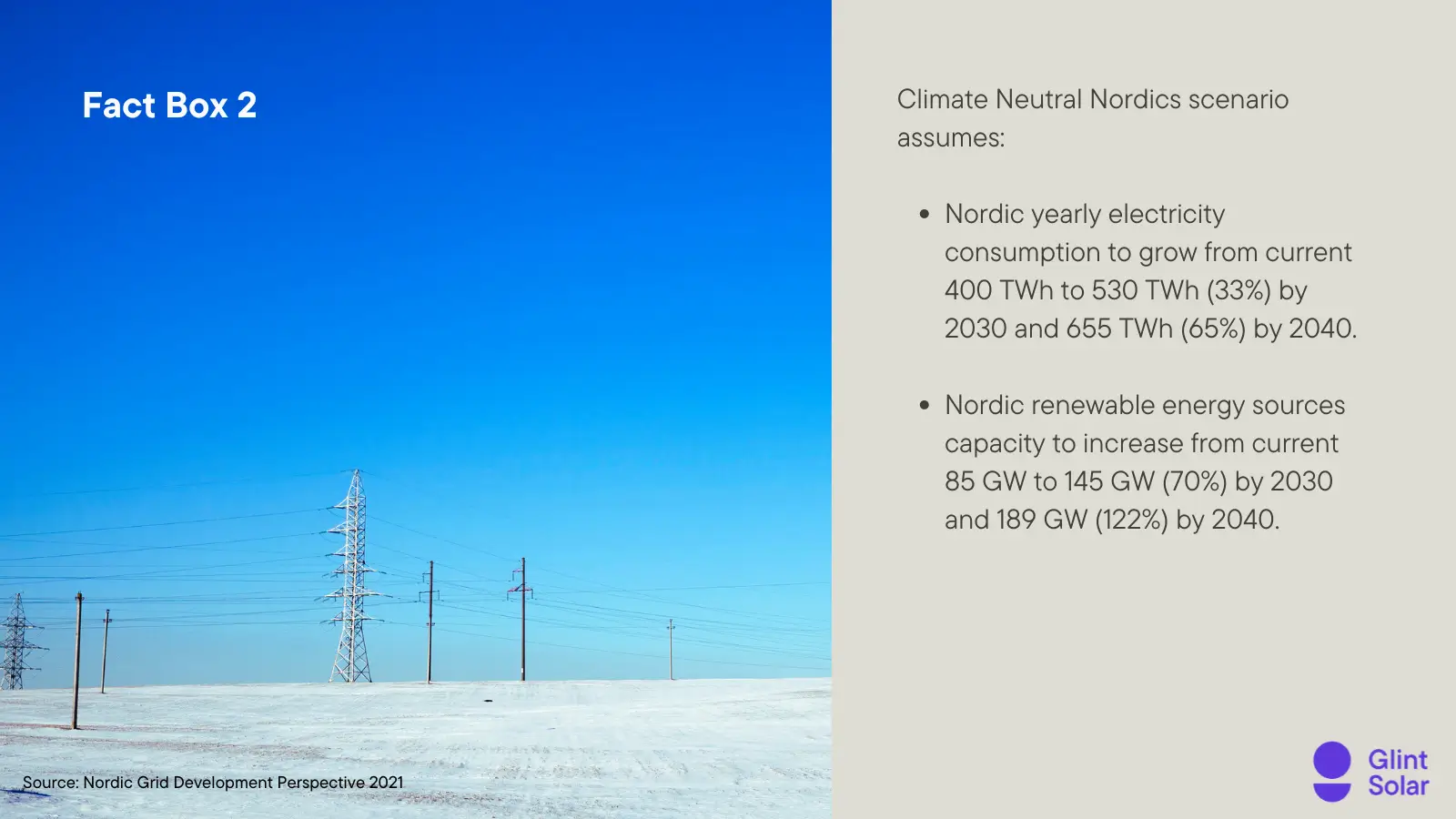

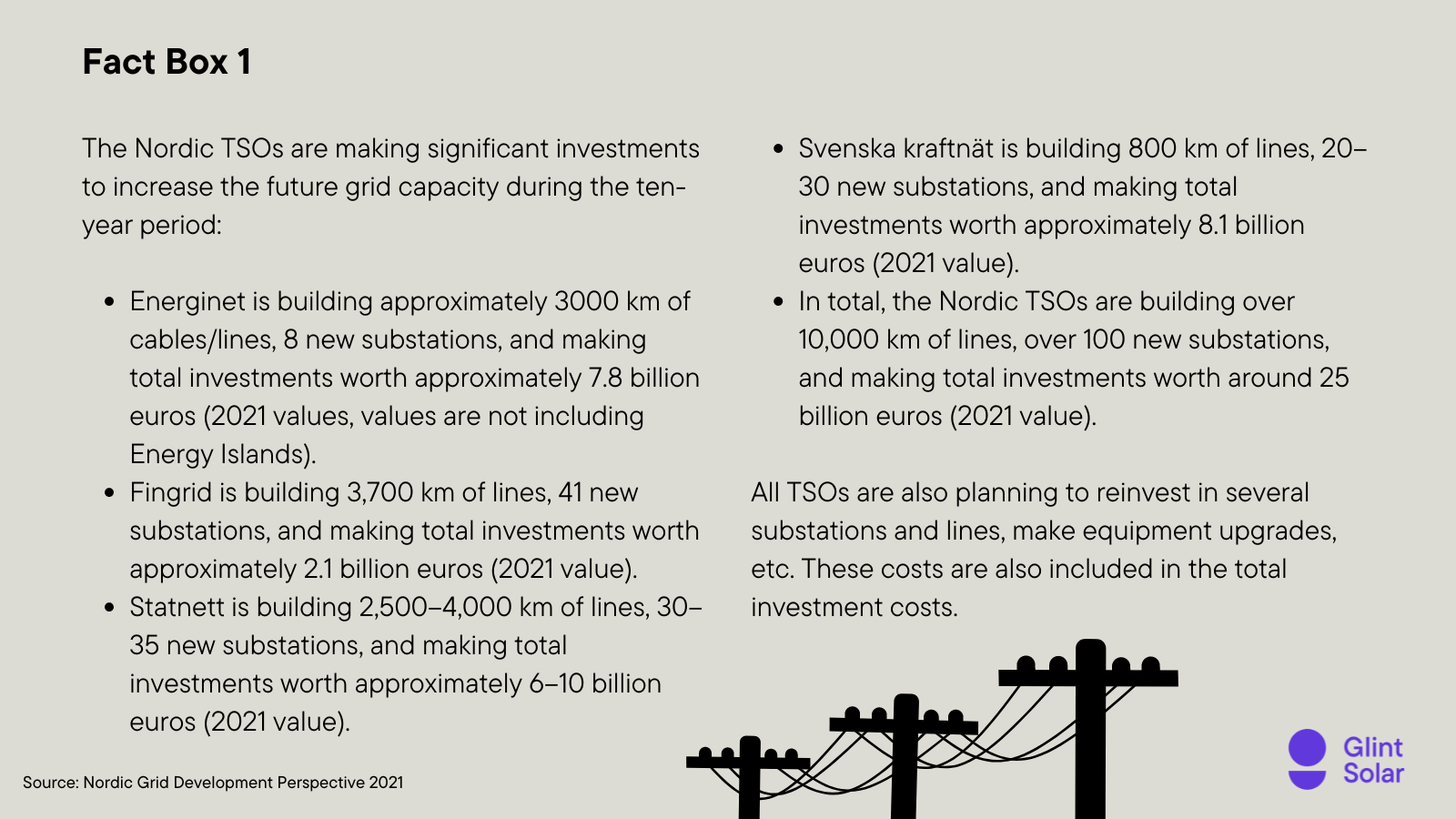

Now, let's go a step further and examine these trends through a national lens, pinpointing opportunities and challenges unique to each Nordic country. This insight will empower solar developers like you to make informed decisions about site selection, collaborate with other renewable projects (such as offshore wind farms), and maximize the economic viability of your solar ventures.

But there's more to it than just that. To navigate this ever-changing situation effectively, we need to analyze it from a Nordic point of view. Moreover, it's crucial to broaden our perspective and look at the bigger picture. This approach will help us assess situations that might cause issues and, as a result, identify opportunities for regional cooperation.




Comparative analysis: Unveiling Nordic Grid systems and what it means for Solar Developers

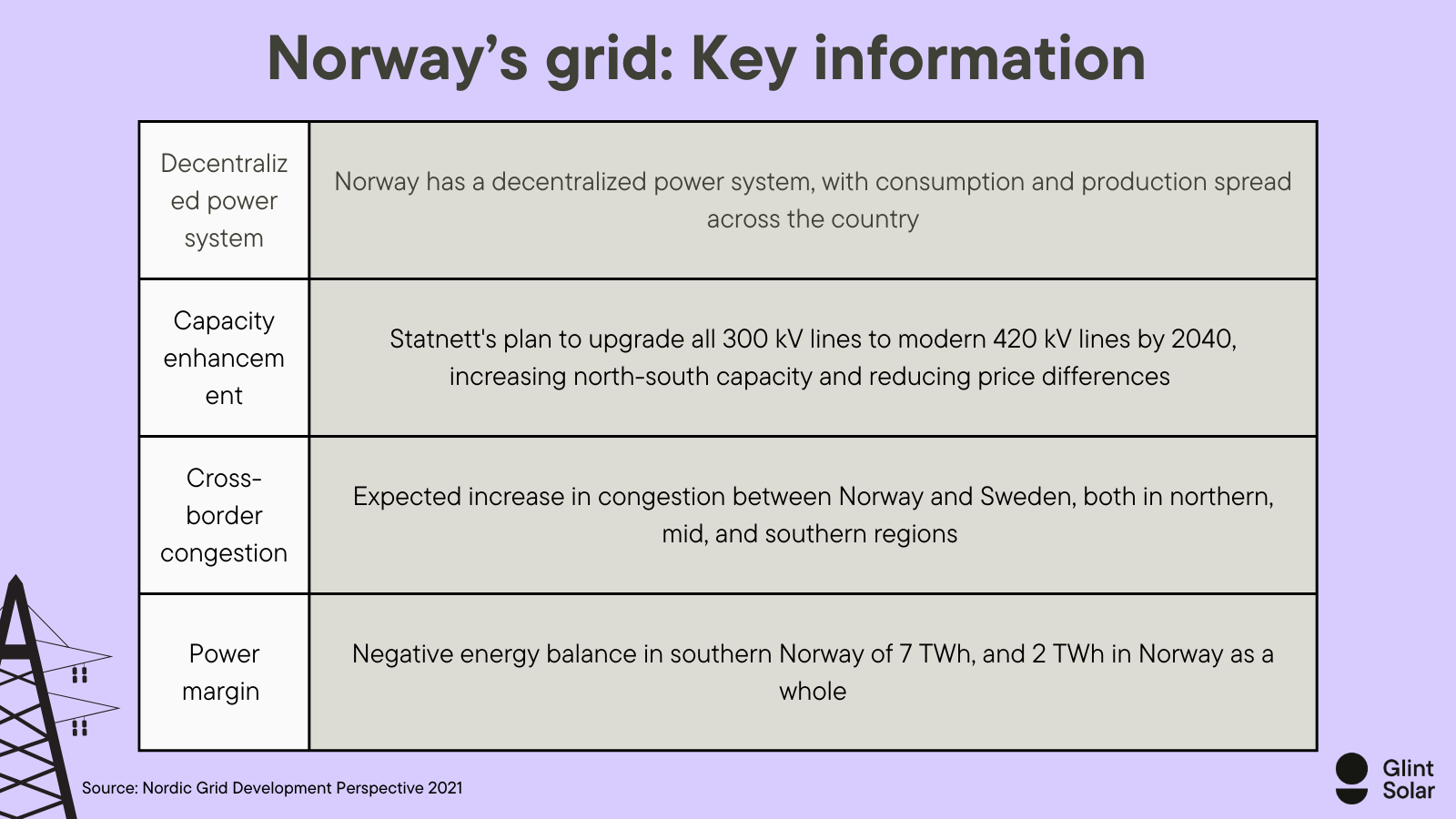

Norway's robust grid

Norway's grid system is robust, and primarily powered by hydropower. This well-established grid infrastructure ensures reliability and stability, making it conducive for solar park integration.

However, the challenge lies in adapting solar projects to complement the existing hydropower capacity, ensuring seamless integration. Solar developers in Norway must also consider grid management practices and collaboration with local utilities to optimize solar power generation while maintaining grid stability.

  • Changing power flow patterns: Norway is experiencing shifting power flow patterns, with increasing electricity flows from the northern and central regions of the country to the southern parts. This trend is expected to continue.

  • Increased industry consumption: The increased power flows from the northern and central parts of the country to the southern regions are partly attributed to rising industrial consumption in these areas. This indicates the potential demand for electricity in these regions.

  • Offshore wind and PV development: The development of more offshore wind and photovoltaic (PV) solar projects in the southern parts of Norway is influencing these power flow changes. This implies that solar PV projects in the southern regions may benefit from proximity to other renewable energy sources.

  • Seasonal variations: It's important to note that power flows from south to north can be significant during hours with a large contribution from solar energy, especially during the summer months. Solar developers should consider the seasonal variations in power generation and consumption when planning solar projects.

  • Grid integration: As a solar developer, you should assess the grid infrastructure and its capacity to handle these power flows. As power flows become more dynamic and variable, knowing the grid integration and stability will be crucial for the success of solar projects.

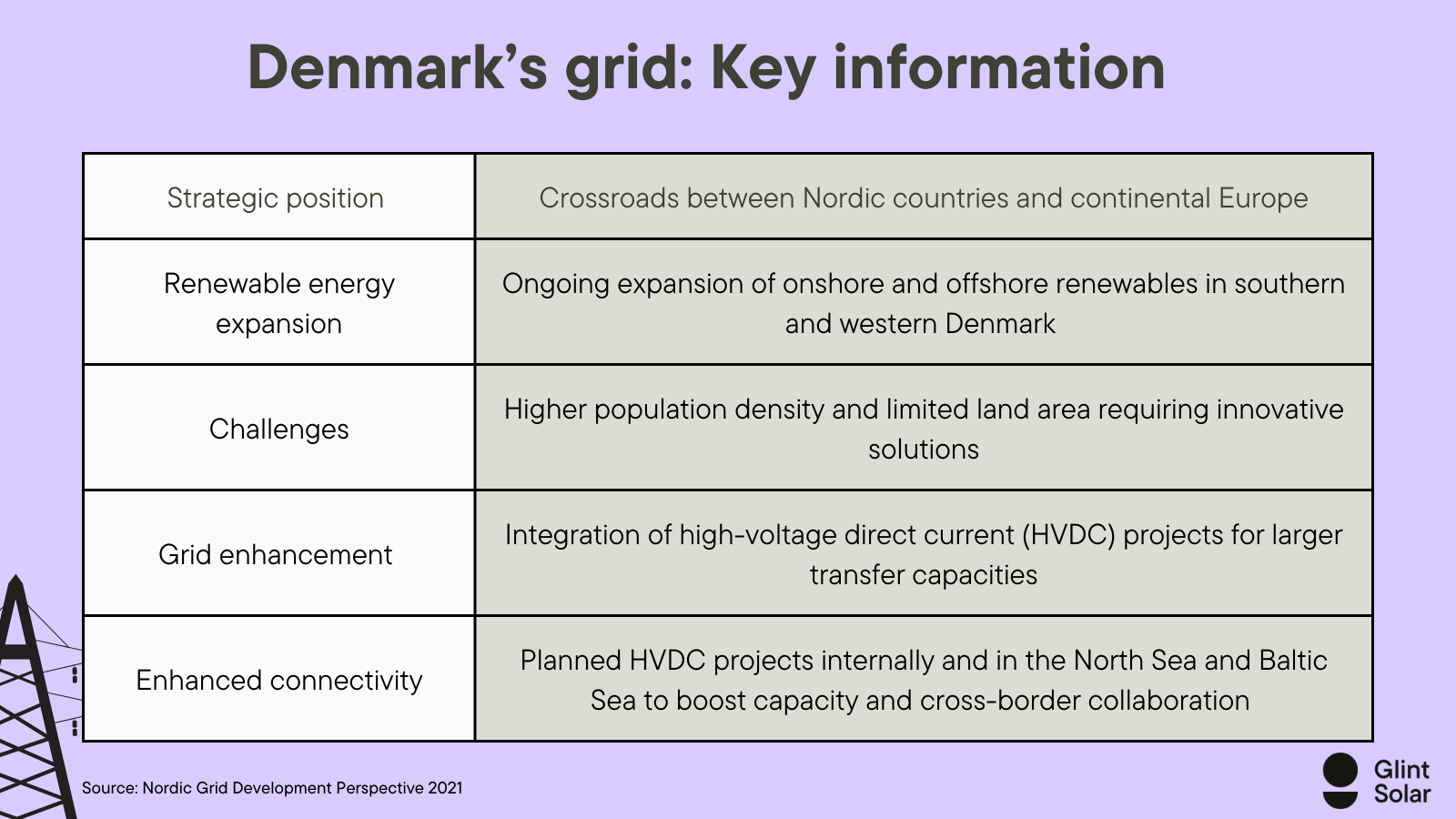

Denmark interconnected grid

Denmark's strength lies in its interconnected European grid, enabling efficient energy exchange.

For solar developers, this means access to a well-established renewable energy ecosystem. Opportunities abound for solar park integration, but competition is fierce.

Developers must navigate regulatory frameworks and market dynamics. Collaboration with local utilities and leveraging Denmark's expertise in wind energy can lead to successful solar projects. Interconnection also offers the potential for cross-border energy trading, enhancing project viability.





  • Grid connectivity: The increased flow of electricity from southern Sweden to eastern Denmark indicates improvements in grid connectivity and capacity in this region. Solar developers can benefit from these upgrades as they can rely on a more robust grid infrastructure for transmitting electricity generated by solar parks.

  • Offshore wind integration: The expansion of offshore wind power in Denmark, particularly in the western bidding zone (DK1), is a positive sign for renewable energy developers. Solar and wind power can often complement each other, both on a daily and a seasonable basis.

  • P2X and electrification: The mention of P2X (Power-to-X) technologies and electrification in Denmark suggests a growing emphasis on decarbonization and renewable energy adoption. Solar developers should explore opportunities to collaborate with projects involving P2X and electrification, as these initiatives may create additional demand for renewable electricity.

  • Interconnectors: The reference to new or existing interconnectors extending through Denmark to the continent is noteworthy. It indicates that Denmark is actively engaged in cross-border energy exchange. This can help you access larger markets and potentially export surplus solar power to neighboring countries.

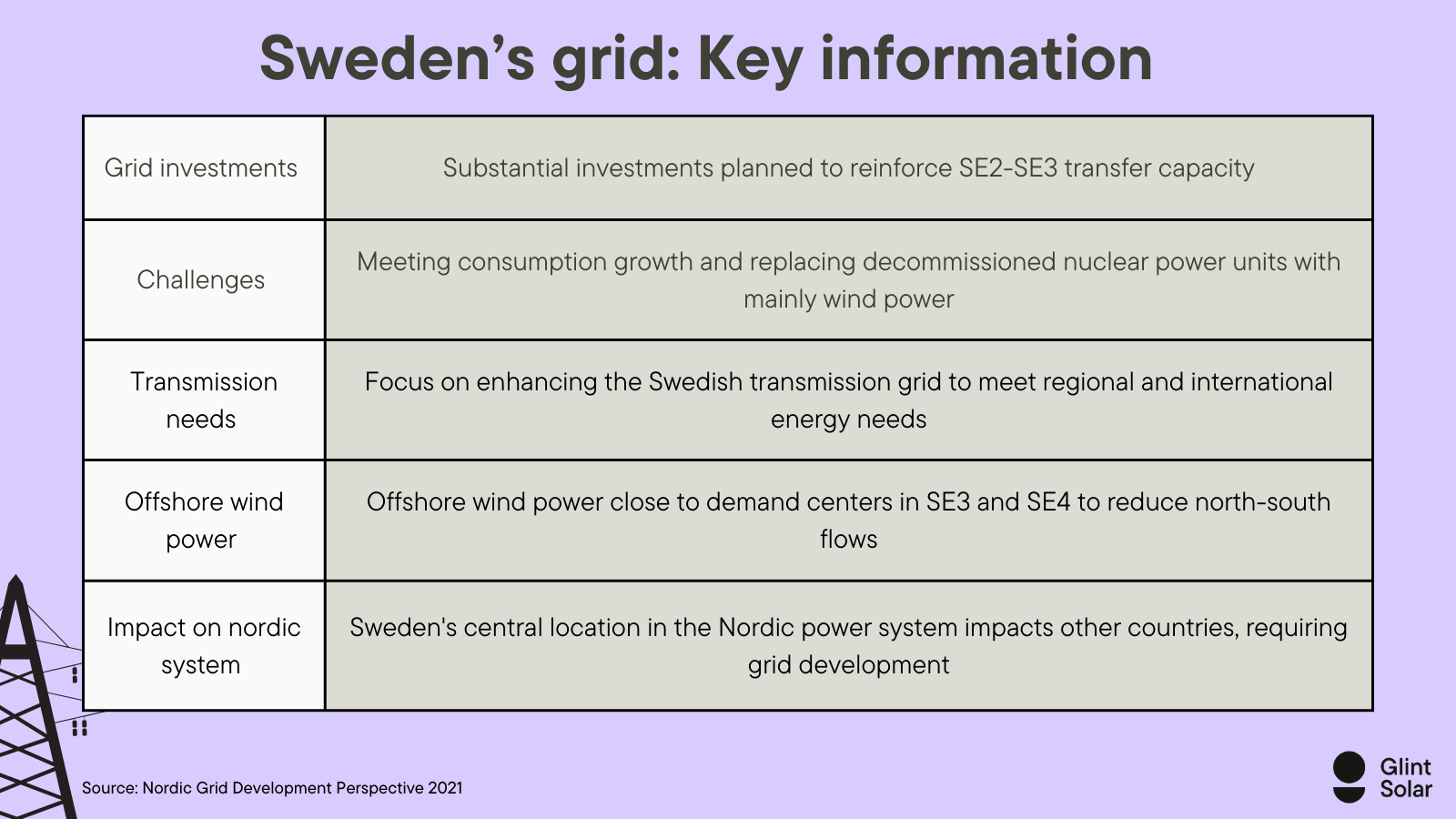

Sweden’s transparency challenge

Sweden's grid transparency challenge is a hurdle for solar developers. The need for readily available grid capacity information complicates site selection and project planning.

However, this challenge presents an opportunity for solar developers to pioneer solutions. Collaboration with local utilities, municipalities, and energy authorities is essential.

Developers must actively engage with grid stakeholders to gain insights into available capacity and streamline project execution. Innovative approaches to grid analysis and capacity assessment are key to overcoming this obstacle.





  • Regional energy deficits: The northernmost part of Sweden (SE1) is projected to face an energy deficit, transforming it from a net exporter to a net importer of energy. This means that SE1 will have a higher demand for electricity than its local generation can supply. As a solar developer, you should be aware of this deficit and its potential impact on the local energy market.

  • Bidirectional flows: The border between SE1 and SE2 will experience bidirectional energy flows, likely due to increased wind power development in northern Sweden and Finland.

  • Continued North-South flows: The border between SE2 and SE3 will continue to see significant north-south energy flows. This suggests there may be opportunities for solar projects in areas experiencing high demand.

  • Changing energy transfer patterns: The border between SE3 and SE4 is expected to transfer less energy on average and become bidirectional. This shift may result from offshore wind power developments in the southern part of Sweden and increased energy imports from continental Europe. Monitoring these changing energy transfer patterns can help you adapt your solar projects accordingly.

  • Collaboration opportunities: Solar developers may explore collaboration opportunities with wind power projects or other renewable energy initiatives to maximize the utilization of available infrastructure and grid connections.

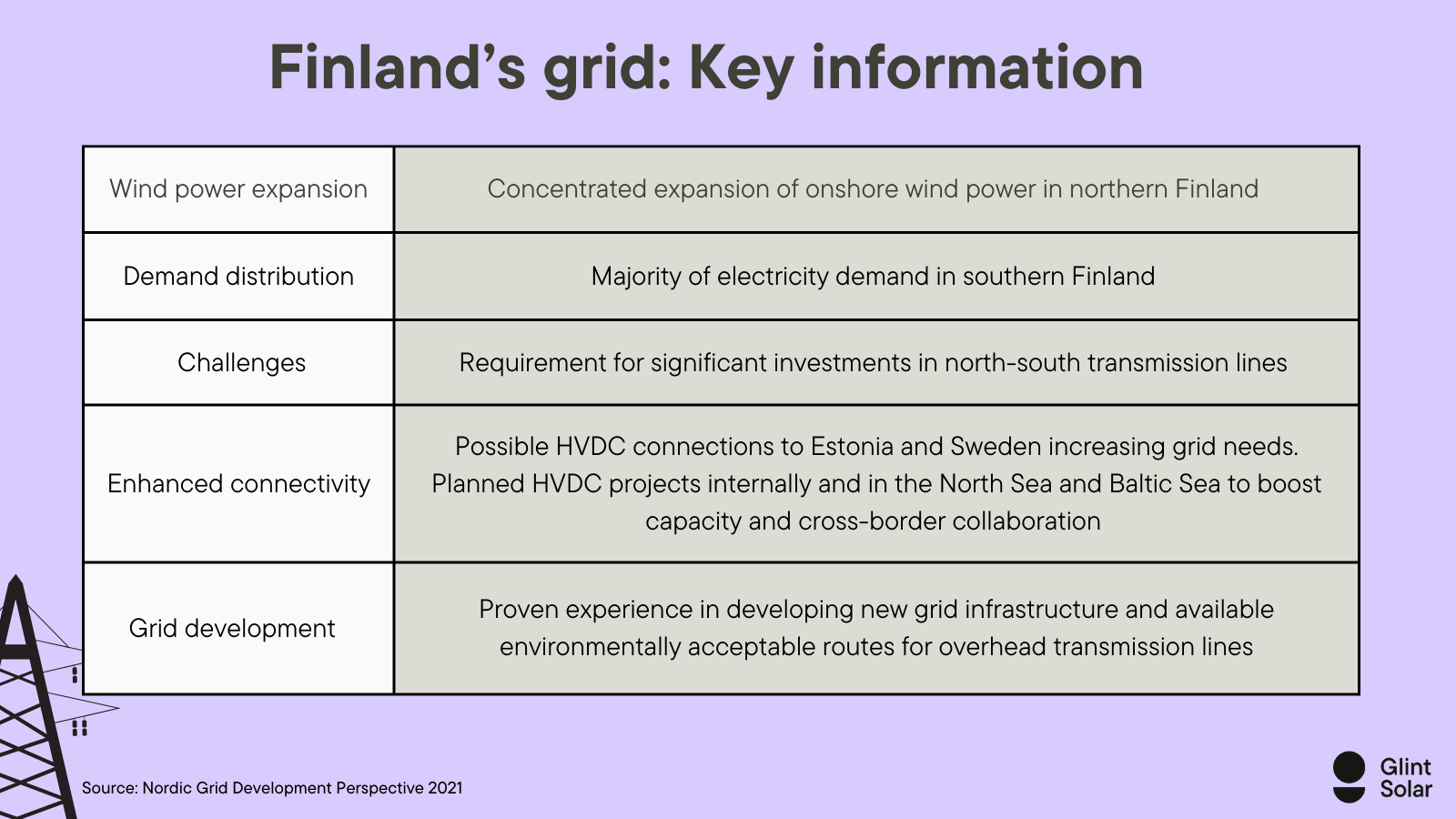

Finland’s unique blend

Finland's energy landscape combines energy efficiency and sustainability. Solar developers can tap into a market driven by a commitment to clean energy. Opportunities exist for solar park development, especially in regions with a focus on renewable energy.

Challenges include adapting solar projects to Finland's unique energy mix and regulatory framework. Collaboration with local partners who share the sustainability vision can facilitate successful solar ventures. Finland's emphasis on energy efficiency offers prospects for grid optimization and intelligent integration of solar power.





  • Increased energy transfer: Finland is expected to experience a significant increase in energy transfer from the northern regions to the southern regions. This suggests that the electrical grid will undergo upgrades and expansion to accommodate this enhanced transfer capacity

  • Onshore wind power: The growth of onshore wind power generation in northern Finland is a positive sign for renewable energy developers. It indicates that there will likely be an increase in overall renewable energy capacity in the country, which can complement solar energy projects.

  • Electricity consumption: The rise in electricity consumption in the southern part of Finland, driven by electrification initiatives and P2X (Power to X) technologies, suggests an increasing demand for electricity. This can create a favorable market environment for solar PV projects, as they can contribute to meeting this growing demand.

  • Bidirectional flow: The shift toward bidirectional energy flow to northern Finland is noteworthy. This indicates that the energy infrastructure is becoming more flexible and adaptable to accommodate varying energy needs.

  • Electrification of heavy industry: The electrification of heavy industry in northern Sweden, which impacts northern Finland, is another positive sign for solar developers. The heavy industry typically requires a substantial and consistent power supply. Solar parks can contribute to meeting these energy demands in an environmentally friendly manner.

The process: Connecting your solar projects to the Nordic grid system

Here's a step-by-step process for solar PV developers looking to connect their projects to the national grid of Norway, Sweden, Denmark, and Finland:



How to connect your solar projects to the Norwegian regional grid

Getting your utility-scale solar project connected to the Norwegian regional grid involves a series of essential steps, ensuring smooth integration with the power system. Here's a brief overview of the process:

Step 1: Assess your project feasibility

Begin your solar project, keeping in mind that spare capacity must be available at all grid levels for production or consumption within the power system.

Step 2: Contact your local grid operator

Reach out to your local grid operator for initial guidance. They will assist you throughout the process and liaise with Statnett, the entity responsible for the highest grid level. Use the Norwegian Water Resources and Energy Directorate's (NVE) atlas to locate your local grid operator on the map. Filter under "grid facilities" (nettanlegg) and "area licensees"(områdekonsesjonærer) in the left column.

Step 3: Grid connection path assessment

In most cases, solar projects are connected through local or regional grid operators. For those requiring major power exchanges (around 300 MW and above), direct connection to the transmission grid may be considered. Your local grid operator, in collaboration with Statnett, will determine the appropriate connection path.

If your project requires a direct connection to the transmission grid, your local grid operator will facilitate the transition to Statnett's customer dialogue process. This typically applies to industrial customers with high power demands or significant power producers. For others, the dialogue remains with the local grid operator.

Step 4: Review the process

Get an overview of the various steps involved in the connection process. Statnett provides information for both local grid operators and direct customers. You can also find answers to frequently asked questions, an inquiry form for capacity requests, and contact details for further assistance on the Statnett page for the grid connection process.



How to connect your solar projects to the Swedish regional grid

Step 1: Assess power requirements

Determine the power requirements for your solar project. Understand the scale of power needed which will dictate whether you connect to the local or regional grid.

Step 2: Identify potential locations

Identify potential locations for your project within Sweden, considering factors like proximity to suitable land, resources, and other operational needs. A tool like Glint Solar can help you find prime solar sites based on your needs and country regulations.

Step 3: Collaborate with NodePole

Engage with NodePole, an organization that aggregates information for future data center establishments. Collaborate with NodePole to explore available power resources in the region where you intend to establish your project.

Step 4: Contact the local distribution system operator (DSO)

Reach out to the local Distribution System Operator (DSO) responsible for the region where your potential project site is located. Submit an application to the DSO to request information on power availability at your chosen plot. The DSO will provide details about power capacity at specific locations. In Sweden three large companies own and manage most of the regional grid: E.ON Power Grids, Fortum Distribution, and Vattenfall Power Distribution.

Step 5: Review power availability

Review the information provided by the DSO to assess the power availability at your chosen plot. Ensure that the available power capacity aligns with your project's requirements.

Step 6: Connect to the grid

Once you have determined the suitability of your chosen location based on power availability, work with the DSO to initiate the process of connecting your solar project or energy-intensive industry to the local or regional grid.

Here’s the link to the Svenska Kraftnät's application form if you wish to connect to the transmission grid.



The Danish grid licensing process

Step 1: New project

The plant owner contacts his grid company and informs them about location, effect size, schedule, etc. for connection purposes.

Step 2: Screening

The network company and Energinet carry out screening analyses of whether the plant must be connected to the distribution or transmission network.

Step 3: Transmission/Distribution

The grid company and Energinet clarify connections in either the distribution or transmission network.

Step 4: Connection

The grid company notifies the facility owner of the decision connection in the distribution or transmission network.

The above 4 steps take approximately 3-6 months.

Step 5: Screening agreement (duration: 6-24 months)

The plant owner enters into a screening agreement per connection with Energinet. The agreement date indicates the plant owner's place in the portfolio of connections. If the plant owner significantly changes information such as location or power quantity,

screening is completed, and the process is started again with new clarification and a new place in the portfolio.  The plant owner pays in advance or provides a guarantee, but only pays for the hours used. If the connection requires changes to the network, Energinet creates a project in parallel and gets the basis for this project approved. The plant owner has 3 months to enter into a maturation agreement. If this deadline is not met, the plant owner's place in the portfolio of connections will be forfeited.

Step 6: Maturation of the project (duration: 6-18 months)

The Plant owner and Energinet enter into an agreement on maturing the project (preparation for the construction phase) which contains a schedule for the project. Energinet performs the necessary calculations and analyses. The plant owner and Energinet enter into a grid connection agreement (covers both the construction phase and the grid-connected

facility) containing i.e. conditions for the construction of the connection station, the establishment of the grid connection point, and the interconnection agreement. Energinet creates the plant in the master data register. The facility receives a GSRN number. The facility owner sends documentation of the agreement with the balance officer.

Step 7: Construction phase (duration: 12-36 months)

The plant owner builds his plant. At the same time, Energinet makes necessary changes to the network.

You can find all the details and links related to the Danish grid connection process here.



The Finnish grid licensing process

Step 1: Contact the local electricity grid operator

Initiate the process by reaching out to the local electricity grid operator responsible for the area where your solar park is located. Request an estimate of connection costs and inquire about the expected timeline for completion.

Step 2: Request a detailed cost estimate

The grid operator is legally obligated to provide you with a detailed and transparent estimate of connection costs. This estimate should include all relevant expenses associated with connecting your solar park to the grid.

Step 3: Verify technical requirements

Ensure that your solar park's hardware and infrastructure meet the technical requirements specified by the grid operator. This step is essential to guarantee that your facility aligns with grid standards and electrical safety regulations.

Step 4: Discuss battery system integration

If your energy plant includes a battery system to stabilize power output, engage in discussions with the grid operator regarding its integration. Address any requirements or agreements related to this aspect of your solar project.

Step 5: Check for additional permits

Depending on the specific circumstances of your grid connection, you may need additional permits for utilities or infrastructure. For example, if the power line used for connection is at least 110kV and is not part of the zoning plan, you may need to apply for permission from the municipality.

Step 6: Review publicly available information

Make use of publicly available information provided by the grid operator. This includes details on the technical requirements for connection, terms of sale, price lists, criteria for determining subscription fees, and a reasonable timeframe for processing network access requests. Ensure you have a clear understanding of these terms and conditions.



Unlocking Nordic solar potential with Glint Solar: Grid complexities simplified


In the ever-evolving Nordic clean energy landscape, Glint Solar offers country-specific capabilities to guide solar developers through the complexities of grid systems. These capabilities include access to vital data such as substations with voltage information, grid lines with voltage data, accurate typography, and parcel proximity to the grid, all of which vary by country. Additionally, Glint Solar provides environmental layers and municipality details to assist in project planning and alignment with local regulations.

To further streamline solar project development and save valuable time in the pre-design process, Glint Solar introduces an innovative 3D project visualization feature. This tool facilitates landowner negotiations and collaboration by offering a visual representation of solar projects and enhancing communication and agreement processes. As solar pioneers shape the future of green energy in the Nordic region, Glint Solar equips them with the essential tools to navigate challenges and seize opportunities.

Ready to experience the benefits of Glint Solar firsthand? Try Glint Solar for free or book a free demo to see the tool in action and discover how it can revolutionize your solar project development process. Save time, streamline collaboration, and pave the way for a sustainable future with Glint Solar.
